Creating a budget
Step 1: Create budget resources for your project
As an example of how to create a budget for your project, imagine that you want to create three budget resources, named Budget-Travel, Budget-Labor, and Budget-Materials. The names that you give to these budget resources will help you to distinguish them from other resources in your project when you categorize them in Step 4.
Step 2: Assign the budget resources to the project summary task
To show the allocated budget for the entire project, you must assign all of the budget resources to the project summary task:
Tip If you have many resources of various types, but want to show only the budget resources, click Resources list options . Select the check box under Filter by, and then click Budget Resources in the list.
Step 3: Enter values for the budget resources
Tip If resource assignments are hidden, click the task's outline symbol to display them.
Note Keep in mind that the Budget Work field includes values for work and material resources. For a work resource, the budget is calculated in hours. For a material resource, the budget is calculated according to the material label created for the material resource. For example, a concrete budget value of 20 that has a material label of Tons displays as 20 Tons in the Budget Work field.
You can also enter budge t work and budget cost amounts for a specific time period by using the timephased (timephased: Task, resource, or assignment information that is distributed over time. You can review timephased information in any available time period in the fields on the right side of the Task Usage and Resource Usage views.) portion of the Resource Usage view. This method is useful when you want to specify that, for example, you want to allocate a certain amount of money per month throughout the duration of a project.
The Budget Work and Budget Cost fields appear as rows. Enter budget values per time period. Keep in mind that you can enter values only for the project summary task.
Step 4: Categorize resource costs according to their budget type
In this step, you categorize all resources, including budget resources, according to the type of budget that each belongs to. You do this by creating a custom text field that contains identifying words or phrases for each budget type. After each resource is categorized in this way, in the next and final step, you group the budget types to see how they compare to the overall budget.
For example, for each person in your project who is actively working on tasks, you might use the word Labor to denote the budget type. For each material resource, you might use the word Materials. For each cost resource that involves travel, you might use the word Travel.
Note Be sure to use these same categorizing words or phrases for the budget resources that are assigned to the project summary task, as well as for the individual work, material, and cost resources.
A custom field named Budget Type has been added to the Resource sheet.

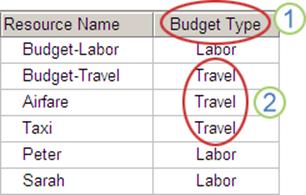

All travel resources, including the budget resource named Budget-Travel, are categorized as belonging to the same type of budget.
The categorizing words and phrases that you have typed in the custom field will be used for grouping in the next step.
Step 5: Group resources to view how they compare against the budget
Resources are grouped by their budget type. You can now view how the cost of resources compares to the overall budget that you set up for the project in Step 3.

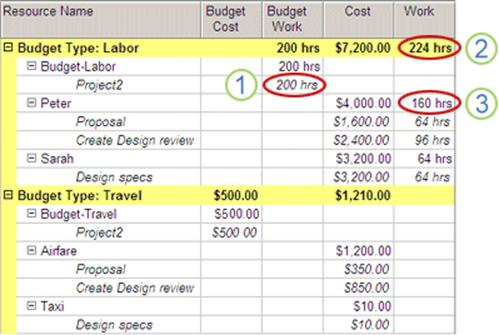

The total budget for work throughout the project.
The total amount of work for all resources on the project. The work assigned exceeds the budget by 24 hours.
The amount of work assigned to Peter.
Tip You can also view a graphical report of your budget. On the Report menu, click Visual Reports. In the Visual Reports dialog box, click the Assignment Usage tab, and then click Budget Work Report or Budget Cost Report. Click View to see the report.
How do you create budgets and track costs against them?
See also
